Parallel work is progressing at the sites of both units

5/4/26, 1:37 PM

The concreting of the nuclear island of Unit 5 is underway, while a quarter of the soil volume from the excavation pit of Unit 6 has already been removed.

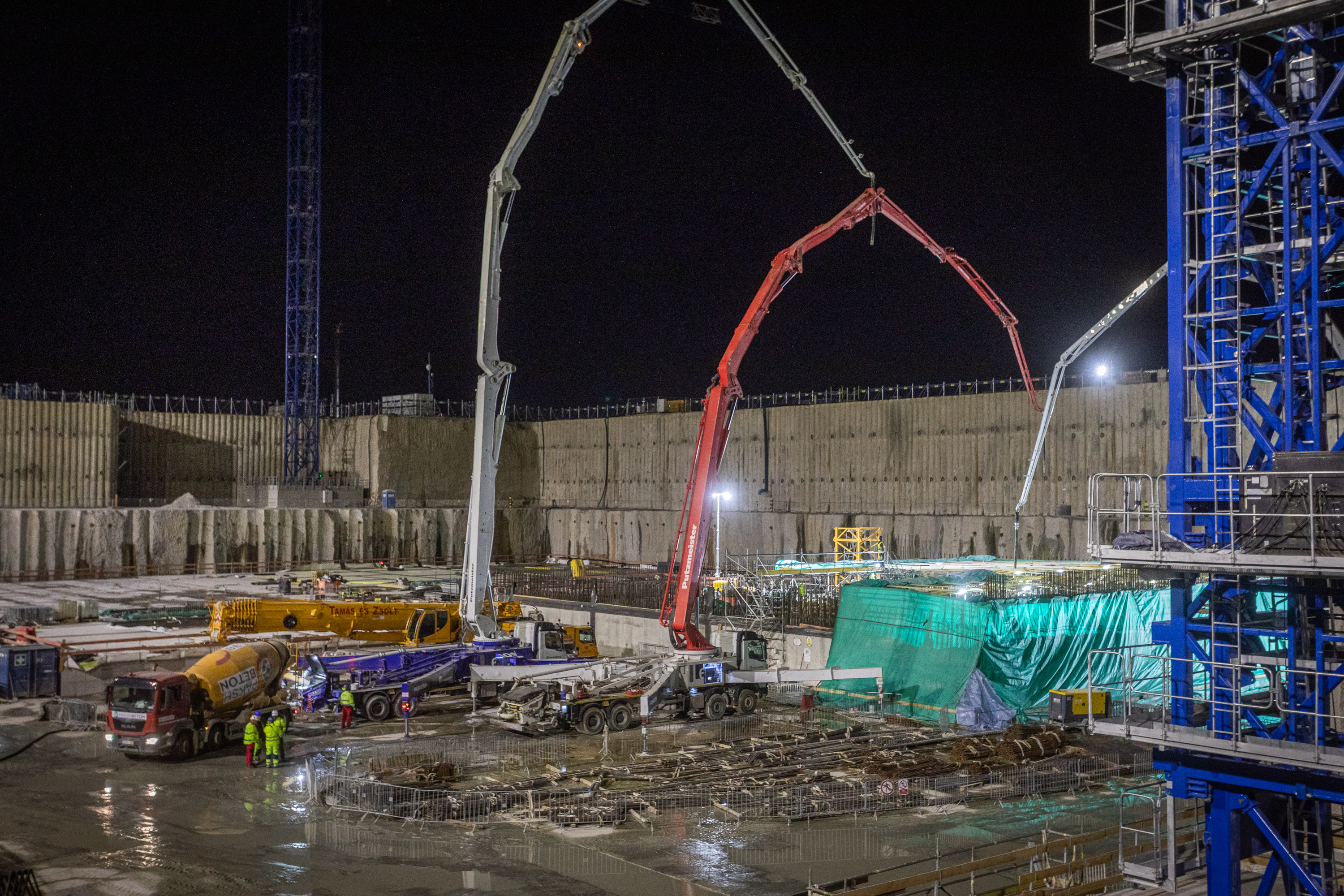

In the bayed excavation pit of Unit 5 the following work processes are taking place in parallel: the placement of levelling concrete, installation of waterproofing and grounding mesh on  the levelling concrete, and the reinforcement installation.  At the end of each phase bays of the foundation slab of the  nuclear island is poured using special concrete. During the most recent phase approximately 1,500 cubic meters of concrete were poured into the foundation slab.
